Steel House Foundation: How the Raft Slab Is Built

The steel house foundation is the subject of a persistent misconception: that a lightweight structure does not need one. In fact, every steel house used as a permanent residence is built on a reinforced concrete foundation, just as a reinforced concrete building is. The most common solution is a raft foundation spanning the entire building footprint; which foundation type is actually used is decided not by the contractor's preference, but by the geotechnical survey report and the structural design. This guide describes the process in Turkey. If you are building in another country, your local regulations will differ. In this article, we walk through the foundation process step by step, from ground preparation to anchor bolts.

Why Is a Steel House Foundation Different?

The difference comes down to weight. A light steel structural system is significantly lighter than a reinforced concrete building of the same size; wall and floor panels are made from thin-walled galvanized profiles. As the structure's weight drops, so does the load transferred to the foundation and the ground beneath it. This has two practical consequences:

  • Ground stress is lower. On ground that would be pushed to its limits by a reinforced concrete structure, simpler foundation solutions may be sufficient for a light steel building. We say "may be", because the decision always depends on the geotechnical survey and the structural calculation.
  • Earthquake load is reduced. The force acting on a structure during an earthquake is proportional to its mass, so a lighter building experiences smaller seismic forces. We covered this mechanism in detail in our article on how steel houses withstand earthquakes.

This lightness does not mean the foundation becomes unimportant — it means the priorities shift. In light structures, the uplift and overturning effects caused by wind become relatively more significant, so securely connecting the structure to the foundation — the anchor bolt detail — becomes more critical than it is in reinforced concrete. Because steel panels are manufactured at the factory to tight tolerances, the flatness and levelness of the foundation surface also directly affects installation quality. These are the two themes that shape light steel foundation design: connection safety and surface precision.

Geotechnical Survey: The Report That Determines the Foundation Type

The starting point of foundation design is the geotechnical survey. Licensed geology and geophysics engineers carry out boreholes and geophysical measurements on site, the samples taken are examined in a laboratory, and the result is a report describing the identity of the ground. The report generally answers the following questions:

  • What layers make up the ground, and what is its bearing capacity?
  • Where is the groundwater level, and are drainage or waterproofing measures needed?
  • Is there a risk of liquefaction or excessive settlement during an earthquake?
  • Which local soil parameters should be used in the seismic calculation?

The design engineer calculates the foundation type and dimensions from the data in this report. In other words, for a steel house the geotechnical survey is not a separate or optional step; as with any permanent building, it is part of the project file submitted for the building permit in Turkey. You can find out where the survey fits into the permit process in our article that walks through the building permit process step by step. To get a general sense of the earthquake hazard in the area where your plot is located, you can look at the Turkey Earthquake Hazard Map published by AFAD, Turkey's disaster and emergency management authority; the values actually used in the project are still determined by the survey report and the structural calculation.

Depending on the survey results, the main foundation approaches that may come into play can be summarised as follows:

Foundation Approach How It Works When It Applies
Raft foundation A single reinforced concrete slab spanning the entire building footprint, distributing the load over a wide area The most common solution for light steel houses; it also provides a flat platform for installation
Continuous (strip) foundation Reinforced concrete strips running along the load-bearing wall lines On ground with suitable bearing capacity, where the project calls for it
Ground improvement / pile solutions The ground is strengthened, or loads are transferred to stable layers through piles On weak, filled, or liquefaction-prone ground

This table should not be read as a menu to choose from: which approach is applied is decided not by the plot owner or the contractor, but by the design engineer working from the survey data.

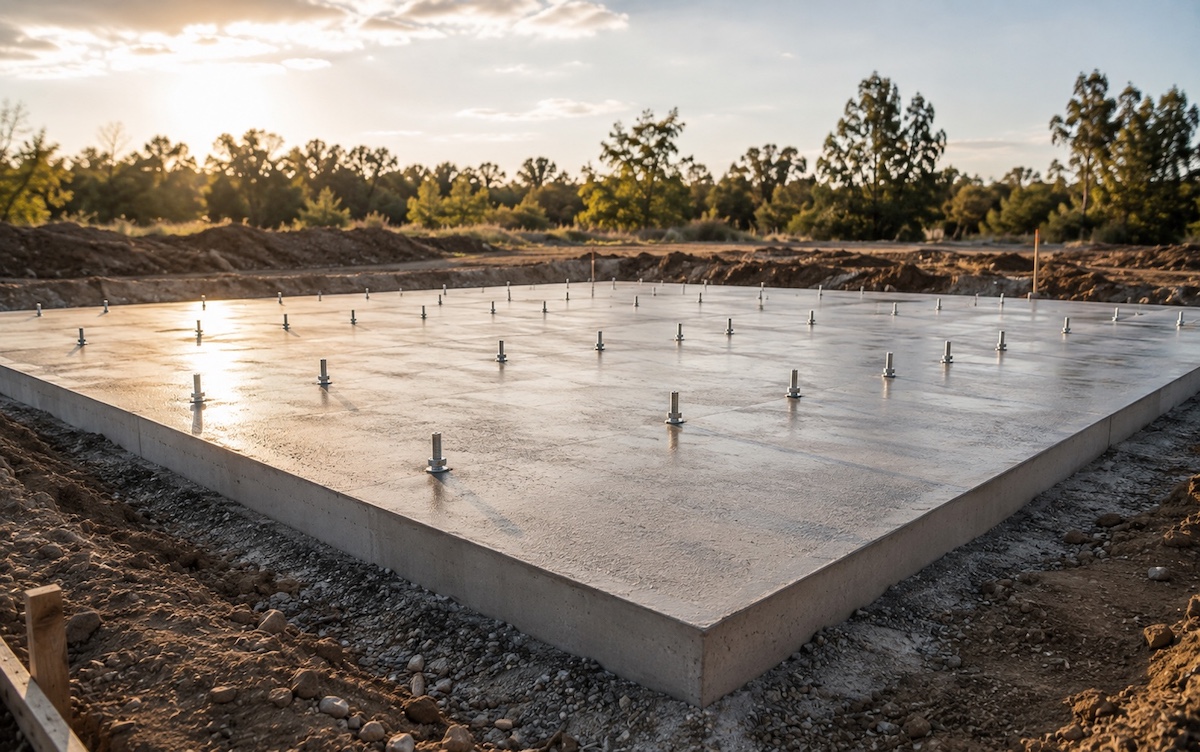

How Is a Raft Foundation Built?

There are two reasons why the raft foundation is the type most often chosen for steel houses: it spreads the load over a wide area, lowering ground stress, and it creates a flat, level platform on which the steel panels can be installed. A raft foundation for a steel house is generally carried out in roughly the following order:

  1. Excavation and levelling: The topsoil is stripped, excavation continues down to the foundation level set out in the project, and the base is levelled.
  2. Fill and compaction: If needed, granular fill is laid down and compacted in layers. The aim is a homogeneous base that will not settle later on.
  3. Blinding concrete: A base concrete layer is poured to create a clean, even working surface.
  4. Waterproofing and utility penetrations: Damp-proofing and waterproofing against the ground are applied; sleeves for the electrical, clean water, and wastewater lines are placed before the foundation is poured. Drilling through the slab for services after the raft has been cast is something to avoid, which is why the planning for this is finalised at this stage.
  5. Formwork and reinforcement: The perimeter formwork for the foundation is set up, and the reinforcement defined in the structural design is placed. Anchor bolt locations are marked out with templates at this stage.
  6. Concrete pouring and curing: The concrete is poured, the surface is screeded, and it is cured in a way appropriate to the climate conditions. No installation load is placed on the concrete until it has reached sufficient strength.

None of these steps has a "standard" slab thickness, reinforcement layout, or concrete class; all of them are determined by the structural calculation specific to your plot. We recommend treating any source that quotes a generic figure with caution. If you are curious where foundation work fits into the overall construction schedule, you can take a look at our article covering the whole construction process.

Why Does the Foundation Surface Matter So Much?

Light steel panels are cut and assembled at the factory to precise dimensions; on site, there is far less room for "making it fit" than there is with reinforced concrete. If the foundation surface has a level difference or is out of plumb, that deviation carries through into the alignment of every panel above it. This is why surface flatness during the raft pour, and level checks after casting, are among the parts of the job that demand the most attention. Before installation, the foundation surface is measured and corrected if necessary.

Anchor Bolts and the Connection to the Structural System

The elements that connect the steel structure to the foundation are called anchor bolts. In light steel systems, a track profile runs the full length beneath the wall panels; this profile is fixed to the foundation with anchor bolts, and the loads coming from the structure are transferred to the raft along this line. The job of the anchor bolts is not simply to hold the structure in place:

  • Earthquake forces tend to create shear between the structure and the foundation; the anchor bolts transfer this horizontal force into the foundation.
  • Wind can create an uplift effect in light structures; the anchor bolts prevent the structure from separating from the foundation.
  • Overturning effects concentrate at corners and at the edges of door and window openings; the connection details for these areas are addressed separately in the project.

The type, number, and layout of the anchor bolts are defined in the structural design; this is not a generic detail picked from a catalogue. As a building rises, the forces transferred to the foundation grow, and so does the importance of the connection details; we covered how many storeys a light steel building can reach in a separate article. What matters on site is that the anchor bolt positions line up exactly with the axes in the project; this is why the installation team checks the axes and levels on the foundation before starting to erect the steel.

Solutions for Sloped and Difficult Sites

A sloped site is not an obstacle for a steel house; the foundation design is adapted to the terrain. Common approaches include:

  • Stepped foundation: The foundation is resolved as a series of steps at different levels along the slope; the structure sits securely on the ground at each step.
  • Basement solution: A basement or half-storey is built into the slope using reinforced concrete shear walls, and the steel structure is erected on top of this platform. The slope is thereby turned from lost space into a usable extra storey.
  • Raised platform: In some projects, the structure sits on a platform carried by reinforced concrete walls, independent of the site's slope; the space left underneath can be used as storage or parking.

The advantage of lightness is felt in these scenarios too: the excavation and retaining works that a heavier structure would need on the same site can, with light steel, often stay more compact. But slope is not the only factor; on sloped sites, surface water drainage and how the ground layers behave along the direction of the slope are also assessed in the survey report. On weak or filled ground, the ground improvement and pile solutions from the table above may come into play. In every case, the solution is designed around the site's own data.

Whose Responsibility Is the Foundation? The Turnkey Scope Question

This is the ambiguity that comes up most often when comparing quotes. The term "turnkey" has no standard definition across the industry: in some quotes, foundation work, the geotechnical survey, and utility connections are included in the scope, while in others these items are left to the building owner's responsibility. A significant part of the difference between two quotes often comes not from price, but from this difference in scope.

So before you place quotes side by side, ask for written answers to the following questions:

  • Who is responsible for the geotechnical survey and the structural design?
  • Is the foundation work — excavation, fill, formwork, reinforcement, concrete — included in the quote?
  • Who is responsible for the utility penetrations through the foundation and the waterproofing against the ground?
  • If the foundation is not ready by the planned date, how is the installation schedule affected?

Scope varies from contract to contract, which is why there is no general rule such as "the foundation is always the contractor's responsibility" or "it is always the building owner's". What matters is that the scope is written into the contract item by item, and that both parties are looking at the same list. This is why, at Özok Steel, we favour discussing scope items one by one during quote negotiations and writing them into the contract. When you are weighing where the foundation sits within your overall budget, our article covering cost headings can give you a framework for comparison.

Frequently Asked Questions

Does a steel house need a foundation?

Yes. Every steel house used as a permanent residence is built on a reinforced concrete foundation that safely transfers loads to the ground and supports the anchor bolt connections. The structure being lightweight does not make a foundation unnecessary — it only reduces the loads placed on it. Foundation-free solutions apply only to temporary structures that are not fixed to the ground and are not considered permanent housing.

How long does a raft foundation take?

It would not be accurate to give a single duration; the schedule depends on the amount of excavation, ground conditions, weather, and how much utility work is involved. The least flexible item is the concrete's curing time: steel installation does not begin until the concrete has reached sufficient strength. A schedule specific to your project is drawn up once the structural design and the execution plan are finalised.

Can a steel house be built on a sloped site?

Yes. The slope is addressed with a stepped foundation, a platform carried on reinforced concrete walls, or a basement solution. The low weight of a light steel structure often simplifies the excavation and retaining work needed on a sloped site. Which solution is applied is decided by the site's slope, drainage conditions, and the geotechnical survey data together.

Is a geotechnical survey mandatory?

In Turkey, for permanent structures subject to a building permit, a geotechnical survey report is a standard part of the design and the permit file; the foundation cannot be designed without it. Because the report's scope and application details can vary with the building and the local municipality, we recommend clarifying the requirements for your plot with your design engineer and municipality.

Can a steel house be built on an existing foundation?

Only if the existing foundation's project and current condition are reviewed and confirmed to be suitable for the structural calculation of the new building. It is not advisable to build on a foundation whose reinforcement, dimensions, and suitability for anchoring are unknown. The design engineer carries out this assessment and, if necessary, recommends strengthening or a new foundation.

To discuss how the foundation process should be planned for your plot, you can get in touch with us, and together we can map out the route from the geotechnical survey through to installation.

This article is for general information purposes. The foundation type, dimensions, and application details are determined by your plot's geotechnical survey report and structural design; for current requirements relating to earthquake and ground regulations in Turkey, we recommend consulting your design engineer and the municipality your plot falls under.
